Toggle menu

Local Highway Maintenance Transparency Report 2025 - 2026

Section 1 - Introduction to our highway network

The Department for Transport requires all local highways authorities to publish information about their highways maintenance activities to help local taxpayers see the difference that funding is making in their areas.

1 Our highway network

Gateshead Council, as the highway authority, has a legal responsibility to maintain adopted highway in the borough (except the A1 and A194(M), which are maintained by National Highways). Most adopted highway has been in existence for many years, but the network continues to change as a result of new development or alterations to existing routes to accommodate modern requirements.

The total length of the highway network in Gateshead is approximately 560 miles (900km). The network reflects the mixed character of Gateshead, ranging from major urban routes carrying large volumes of traffic to more lightly used rural roads some over 200 metres in altitude providing access to outlying villages and farms. It includes 740 miles (1191km) of footway, 32,000 streetlights, 289 bridges and other highway structures, and 170 traffic signaled junctions or crossings.

Gateshead's position within the Tyneside conurbation means that, as well as catering for local traffic, there are significant amounts of travel through the area to and from adjoining areas. The Newcastle / Gateshead urban core (including Newcastle city centre) is the main regional centre for shopping, leisure and employment providing over 80,000 jobs, and draws on a wide regional catchment area. This results in additional pressures on the main cross boundary routes from commuter and other traffic. These are intensified by the limited number of river crossings, which means that traffic converges at a small number of points on the network. The council shares maintenance responsibilities with Newcastle City for a number of bridges across the Tyne.

Table 1.1 Lengths of highways, footways and cycleways

Type of highwayLength in kilometres (km)
A road78.1
B and C road141.4
Unclassified roads682.2
Total roads901.7
Footways1191
Other public rights of way254
Cycleways178.2

Section 2 - Highways maintenance spending

Table 2 Annual financial allocations

Financial yearCapital allocated by DfT (£)  Total capital investment Council and DfT (£) Revenue spend (£) % spent on preventative Maintenance
(Capital)
% spent on reactive maintenance (Revenue)
2025/26 * 5,413,000*8,586,000*4,577,612*65*35*
2024/25 4,797,1298 688,2484,400,9906634
2023/244,331,957 7,734,7054,609,2616337
2022/234,490,6176,870,886 3,802,2906436
2021/224,012,7207,961,8143,871,5026733
2020/216,107,9138,519,7503,053,7747426

* Estimate

2.1 Reactive (revenue) budget types of activity

In general, the reactive maintenance budget is used for immediate and urgent repairs needed to keep the highway and pavements safe for all customers. Issues reported online or picked up by our five area inspectors may be anything from a pothole to broken flag or damaged gully and can be expensive during poor weather such as flooding, frost or high winds which can cause problems for signs.

The numbers of defects are carefully monitored as is the budget at our quarterly Highway Asset Management Working Group. Problem issues can then be addressed at the meeting and preventative capital schemes used to address areas of constant pressure and repeat repairs. This may be a new drainage system where the existing infrastructure is failing or a resurfacing or reconstruction scheme where constant reactive repairs are failing.

Table 2.1 Annual repair costs

Repair2018 to 20192019 to 20202020 to 20212021 to 20222022 to 20232023 to 2024
Footway kerb7,2695,1883,8913,5403,5264,190
Potholes4,4013,1202,8923,1092,9404,176
All Repairs17,415 12,81911,332 *13,00713,38016,359
Cost (£)1,510,9941,147,9851,190,3851,418,4261,401,4021,809,016


Repair numbers and subsequent costs for reactive maintenance fluctuate from year to year depending on the weather.  2018 being a cold winter led to increases in pothole repairs due to the freeze thaw effect on the carriageways. Similarly, 2023 to 2024 was very wet and cold with many potholes and blocked gulleys.

Footpath repairs, broken flags and kerbs make up the highest proportion of repairs annually, making up an average of 33% of all repairs (table 2.1 above).  Potholes make up on average 24% of the total number of reactive repairs with the council spending an average £343,967 on repairing potholes annually from the reactive maintenance budget since 2020.

Table 2.11 Estimate of the number of potholes filled using reactive maintenance budget

Financial yearNumber repaired
2024 to 20253476
2023 to 20244176
2022 to 20232940
2021 to 20223109
2020 to 20212892

2.2 Preventative (capital) maintenance

The capital budget is used for preventative maintenance for larger planned schemes such as the resurfacing and replacement of carriageways and footpaths. It is also used for bridge and structural repairs, street lighting and flooding investigations and small schemes. The schemes are selected from the annual surveys and inspections of the network as well as requests from our residents and council members.

The council is always looking to boost preventative maintenance spending with extra capital spending (prudential borrowing) in key areas such as footpath repairs, unclassified roads and traffic signal maintenance to reduce the burden on the revenue funded reactive maintenance budget. We have an invest to save project for street lighting modernisation and replacement of ageing columns which is driving down energy costs and reducing the number of reactive repairs.

All of the council's structures are part of an ongoing inspection programme set out in section 3 of the council's Highway Maintenance Plan on the council's website.

Programmes of capital work are determined from the inspections and details of the 2025 to 26 programme are shown in section 3 of this document.

The council is actively targeting the unclassified highway network which is much larger than our classified A, B and C road network and is generally in a poorer condition (see Table 2.2).

Extra council capital funding using prudential borrowing has been used to fund a large-scale thin surfacing programme since 2020 initially with micro-ashphalt and now with Ultithin - another form of thinner surfacing ideal for unclassified roads with low traffic volumes. This is part of our plan to repair and resurface greater lengths of road using appropriate materials for the road type.

Table 2.2 Planned maintenance capital programme 2024 to 2025

Asset GroupDescriptionLength (km)Cost (£) Budget proportion (%)
1A road1.8252,914  8.6
2B road1.4374,12812.7
3C road3.7 575,64719.6
4U road9.41,731,60859.1
 Total16.32,934,297 100

Details of all the proposed carriageway and footway programmes for 2025 to 2026 are shown in section 4.

Updates on all scheme proposals are also always on the council website.

The council works closely with its partners such as Northumbrian Water and the Environment Agency to develop major flood alleviation schemes.  However, there are many smaller capital funded schemes related to the highway network that are carried out using the Capital preventative maintenance budget each year.  In 2024 to 2025 we commenced a programme of gully repairs where damaged drainage infrastructure required a small capital scheme, over 50 such schemes are planned over the next two years to remove the burden from the reactive maintenance budget. Programme details for 2025 to 2026 are provided in section 4.

The council's reactive maintenance spends is, as explained, often determined by the weather so a key aim is to make what is a fragile network more resilient by increasing the proportion of funding dedicated to preventative maintenance. This funding may be from central government initiatives or local prudential borrowing

Section 3 - Condition of local roads

Road condition assessments on the local classified road network in England are currently made predominantly using surface condition assessment for the national network of roads (SCANNER) laser-based technology.

The unclassified highway network is surveyed using a coarse visual or manual survey with trained inspectors. (CVI)

A number of parameters measured in these surveys are used to produce a road condition indicator which is categorised into three condition categories:

  • Green - no further investigation or treatment required
  • Amber - maintenance may be required soon
  • Red - should be considered for maintenance

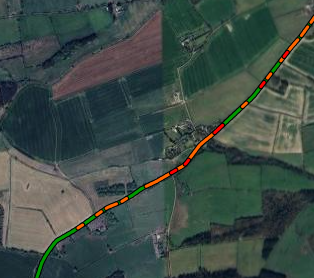

A typical example is shown on figure 1.

Surveys are carried out annually in Gateshead across the network and the results are published both by the DfT and by the council on their website. The survey data is downloaded onto the council's asset management software application and used to direct the annual highway maintenance programmes.

Figure 1 Highway condition

Road condition

3.1 Situation in Gateshead

The A, B and C roads in Gateshead are in a good condition; ranked in the highest road condition quartile of local highway authorities across the country. As an authority we can keep on top of repairs on these roads using capital planned maintenance budgets and targeted interventions using the latest asset management software to model current and future life expectancy.

The condition of the unclassified network (residential and industrial estates) is poor however with a backlog of 123 km in need of repair (Table 3.1). We have targeted considerable resources using different methods and techniques in the last three years to this area, the backlog of unclassified roads requiring repair has tended to remain constant at around 20% of the unclassified network indicating the extent of the problem however the latest results show an improvement for the first time in seven years.

As our neighbouring authorities have similar backlog issues on their unclassified roads the issue has been raised with the North East Combined Authority and is flagged up in the regional Transport Asset Management Plan. We continue to target the unclassified network as shown in (Table 2.2) with almost 60 % of spend in that area but annually this is still less than 10 km of the 123 km estimated backlog.

Longer term extra capital funding has been provided by government in 2023 to 2024 and onwards to 2027 including the additional Network North funding (from the cancelled HS2 project) and Pothole funding. The regional TAMP also provides certainty of funding and it is hoped this will draw the condition indicator down and away from the existing "steady state".

Table 3.1 Percentage of road network that should be considered for maintenance in Gateshead

Road classLength (km) 2017 to 20182018 to 20192019 to 20202020 to 20212021 to 20222022 to 20232023 to 20242023 to 2024
Principal78.111111111
B and C141.422222222
Unclassified682.21820192024212118

Table 3.2 Road condition categories by year

Year% of A roads in
 red category
% of A roads in
   amber category
% of A roads in
    green category
2020 to 202111089
2021 to 202211089
2022 to 202311089
2023 to 202411188
2024 to 2025 11188
Year% of B/C roads in red category% of B/C roads in amber category% of B/C roads in green category
2020 to 202121682
2021 to 202221682
2022 to 202321484
2023 to 202421484
2024 to 2025 21484
Year% of U roads in red category
2020 to 202120
2021 to 202224
2022 to 202321
2023 to 202421
2024 to 202518

3.2 Gateshead's unclassified network

The unclassified network makes up over 75 % of the total highway network at 682 km and although very urban in nature in the east and centre of Gateshead, in the west it is very rural with country lanes and some steep inclines to the Derwent and Team river valleys.

This has led to different issues arising in certain areas although the western unclassified network has lower volumes of traffic upon it the roads are more susceptible to the freeze thaw process and are not always suitable for thin- surfacing products which would be appropriate on housing estates in the built-up areas. Our strategy has been to use thin surfacing on unclassified urban roads with low traffic volumes identified as red on the CVI surveys but also with high volumes of reactive maintenance repairs. In the rural west some repairs have had to be more extensive although we have had success with jet patching in certain areas.

The council has provided extra funding to address the backlog of works on the unclassified network with prudential borrowing over the last four years to help the situation, but we would need to invest much greater funding to begin to drive down the backlog of works accrued on the unclassified network.

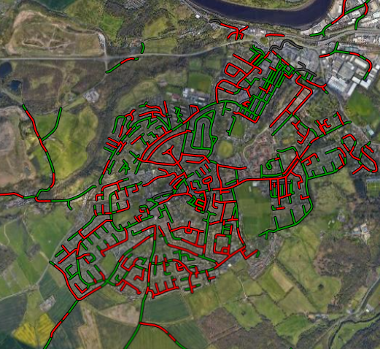

Figure 3.2 Unclassified network condition Winlaton Gateshead 2024

Winlaton

Green = up to standard

Red = work potentially required

Section 4 - Plans and programmes 2025 to 2026

4.1 Overall strategy

Gateshead Highway Asset Management Plan (HAMP) / Highway Management

The Gateshead HAMP provides the strategic framework for the management of the highway network in Gateshead. It is updated annually and reported to the Council's Cabinet. It provides the latest performance information and details progress with the key targets that have been set. The HAMP has two other key documents which provide the detail required to direct the management of the highway they are the Highway Maintenance Plan and the Highway Asset Management Framework both of which are available on the council's website.

The council has a HAMP working group where senior officers look at quarterly performance with targets and monitor scheme progress and financial management.

Outcomes from investment in the asset are monitored closely to make sure they align with strategies.

The council understands the value of highway asset management as an effective way to manage limited resources and has been developing their highway asset management plans since 2014. On the following principles:

  • Data driven based on objective information - using credible and current data such as routine condition surveys, safety inspections, customer reports,
  • Objective driven - with resource allocation decisions based on clear policy goals and objectives.
  • Performance based - policy objectives translated into performance measures that are used for day-to-day management and for strategic management.
  • Monitoring and review - performance results are monitored and reported for their impacts

A full list of policies and targets is in section 6 of the Gateshead Highways Asset Management Plan 2018 to 2030

HAMP Targets 2024 to 2025

 Action / target PriorityProgress 2023 to 2024 and target 2024 to 2025 Status


Strategic / general


1The development of life cycle plans for different asset types in Gateshead.HighLife cycle plans now available for all assetsAmber
2

Assessment of the impacts of climate change for future maintenance regimes.

Development of carbon measurement (carbon calculator for materials).

Development of a decarbonisation strategy for highway infrastructure maintenance

High

Conversion of traffic signal installations to LED now high priority to provide carbon/energy savings and reliability gains. Grant received from DfT.

Conversion of all street lighting lanterns to LED complete. Carbon/ energy savings being accrued.

Tarmac partnership commenced with carbon reduction baseline for 2023 to 2024.

New warm mix and ultra thin products now being used to replace more traditional higher carbon materials.

Programme to continue in 2024 to 2025.

Amber
3Review inspection and repair policy to reduce repair numbers using new risk-based code of practice.High

New risk related highway inspection policy now achieving target to reduce repair numbers and improve repair times.

New policy continues to provide benefits in safety and cost savings in 2023 to 2024.

(Continue to monitor performance 2024 to 2025.)

Green


Maintenance programmes


4To arrest the declining condition of the council's unclassified carriageway network (residential estate roads) to bring it in line with other Northeast authorities. HighExtra funding continues to be targeted into this area. The decline may have been arrested; improvements may require more resources.Amber
5Deal with the increasing incidences of potholes in carriageways using new methods and techniques where appropriate.HighExternal funding provided to assist in 2023 to 2024; however, numbers fluctuate being dependent on weather.   Amber
6Replace obsolete traffic signals equipment with new longer lasting and more energy and carbon-efficient equipment.High

Maintenance programme commenced guided by the Imtrac asset management system.

(Ongoing seeking further funding.)

Amber
7Develop evidence-based ward programme for improving footway condition based on footpath hierarchy, condition, and defect records.High

Utilised extra funding and used new footway maintenance survey (FMS).

In 2023 to 2024. To continue in 2024 to 2025

Amber
8Assess and where necessary act to remedy geotechnical problems.HighNew area at Lintzford Road A694 to be addressed.Amber
9Tackle problems relating to vehicle restraint systems.HighFull survey conducted and repair programme commenced.Green
10Develop programme for the continuous replacement of older lighting support columns.High2850 new lighting support columns have already been planted as part of the ongoing column support replacement scheme.Amber
11Structural testing of lighting columns.HighStructural programme of replacement ongoing.Amber
12Tackle deteriorating condition of signs and road markings.MediumExtra funding provided and programme of works continues.Amber
13Improve the management of 30,000 highway drains/culverts using a new risk-based approach to target critical locations. HighNew computerised management system now fully operational (2023 to 2024). Analysis of first 2 year's data to develop a new drainage strategy (2025). Amber
14Carry out bridge and structural inspections programme using bridge management software.HighOngoing programme of general and principal inspections of all highway structures.Amber


Information / analysis


15Improve links to actual cost information for schemes.High

Some work completed.

(Ongoing)

Amber
16Link footway inventory data to asset database.MediumCompletedGreen
17Identify future approach towards updating inventory information.MediumNew asset information strategy completed.Green
18Develop new skidding resistance policy and work programme expanded to B and C roads.High

Network analysis completed. Second year of B and C road surveys completed and remedial work underway.

Policy requires an update.

Amber
19Update Imtrac traffic signals asset management system to manage performance and future maintenance programmes. Fault reporting system to be centralised.High

Inventory now updated. Allowing accurate billing, life cycle planning and fault reporting.

(Complete)

Green

4.11 Best practise delivering innovation and efficiency

Gateshead Council asset officers meet regularly with their colleagues in the North East Combined Authority area to share best practise and benchmark service provision and share ideas on innovation. Repair times and standards have been successfully improved after benchmarking and new customer focused reporting systems introduced.

During 2023 to 2024 a more targeted approach was taken to footpath repairs in Gateshead. Higher risk areas with greater footfall such as in local centres, outside hospitals, schools and residential homes were given a greater priority after initially looking at the condition surveys, local feed-back and our reactive repair records.

The programme also received extra internal funding and so far over 5000m2 of footpath at a cost of £300,000 has been repaired with this programme which commenced in 2023 to 2024 and has continued into 2024 to 2025.

The council has been gradually converting its traffic signals from tungsten halogen to LED which has brought with it great efficiencies in not only carbon savings and electricity costs but also reduced the numbers of repair visits. The council has also trialled various low carbon materials for resurfacing roads from warm lay materials as opposed to hot rolled asphalt that exhibits much higher carbon production.

Other new products such as Ultithin which is a thin surfacing material suitable for lightly used estate roads are now being extensively used. Like other thin surfacing products this is a layer added to an existing surface to extend its life without the planing out and subsequent transport costs in finance and carbon. This product appears to have the advantage in terms of life expectancy over some other products we have tested in Gateshead.

We have trialled various products to deal with potholes including jet patching and have now decided to use the pothole pro from JCB this summer.

Our overall annual carbon output from materials used in highway maintenance is monitored annually. Our future aim is to continually look at new products and ways of reducing our carbon footprint in the processes involved in highway maintenance.

Section 4.2 - Specific capital maintenance plans for 2025 to 2026

4.2 Carriageway resurfacing /reconstruction 2025 to 2026

4.21 Classified and bus routes

LocationReason for works being undertakenIndicative cost (£k)Length kmBenefits
A184 Consett route/slip roadSurface/binder course failure67337Extend life make safe
A184 Felling bypassSurface/binder course failure71118Extend life make safe
A694 Spa Well RoadLoss of skid resistance    55175Safety
A1114 Riverside WayLoss of skid resistance    2050Safety
A1288 Birtley LaneSurface/binder course failure3970Extend life make safe
C302 Lead Road, Greenside    Surface/binder course failure in carriageway64240Extend life make safe
C305 North Street, WinlatonSurface/binder course failure in carriageway55150Extend life make safe
C307 Dunston Bank, DunstonSurface/binder course failure in carriageway92180Extend life make safe
C308 Pennyfine Road, SunnisideSurface/binder course failure in carriageway49245Extend life make safe
Victoria Road, BenshamSurface/binder course failure in carriageway72268Extend life make safe
C326 Askew Road West, RedheughSurface/binder course failure in carriageway50130Extend life make safe
Saltwell View, Saltwell    Surface/binder course failure in carriageway86206Extend life make safe
C315 Coatsworth Road / Whitehall Road, Bensham    Surface/binder course failure in carriageway47103Extend life make safe
C313 Easedale Gardens/Springwell Road/Stanley Gardens, WrekentonSurface/binder course failure in carriageway4580Extend life make safe

4.22 Unclassified roads

LocationReason for works being undertakenIndicative cost (£k)Length kmBenefits
Strothers Road, High SpenSurface course failure in carriageway24133Extend life make safe
Stella Bank, Stella - Low prioritySurface course failure in carriageway1085Extend life make safe
Ancrum Way, WhickhamSurface course failure in carriageway1365Extend life make safe
Prospect Terrace, KibblesworthSurface course failure in carriageway16110Extend life make safe
Mourne Gardens, Lobley Hill - Low priority.
Condition is reasonable
Surface course failure in carriageway14106Extend life make safe
Seventh Avenue, Team ValleySurface/binder course failure in carriageway49101Extend life make safe
Windermere Street West, Bensham. Surface course failure in carriageway33155Extend life make safe
King Street, BenshamSurface course failure in carriageway23119Extend life make safe
Cross Keys Lane, Low FellSurface/binder course failure in carriageway22122Extend life make safe
Harewood Green, Bedale Acomb Court, Allerdene.Surface course failure in carriageway30140Extend life make safe
North Dene, BirtleySurface course failure in carriageway29170Extend life make safe
Taylor Gardens, PelawSurface course failure in carriageway1687Extend life make safe
Ryhope Gardens, WrekentonSurface course failure in carriageway24105Extend life make safe
Suffolk PlaceSurface course failure in carriageway40210Extend life make safe
Elder GroveSurface course failure in carriageway2095Extend life make safe
Dorset AvenueSurface course failure in carriageway10100Extend life make safe
Windermere Street West (rear)Surface course failure in carriageway15112Extend life make safe

4.23 Back lanes

LocationReason for worksCost £kLength (metres)    Benefit
Derwent Street, ChopwellSurface course failure870Extend life make safe
Litchfield Terrace, WinlatonSurface course failure870Extend life make safe
Eleanor Terrace / Edith Terrace, WhickhamSurface course failure23157Extend life make safe
Ravensworth Terrace, DunstonSurface course failure21143Extend life make safe
Caris Street / Roseberry Avenue, DeckhamSurface course failure19150Extend life make safe
Beacon Rise, Sheriff HillSurface course failure1060Extend life make safe
Rochester Terrace / Bondene Avenue West, FellingSurface course failure19125Extend life make safe
West Row / Penshaw View, BirtleySurface course failure20193Extend life make safe
Chilcrosse (Bleachfield), Leam LaneSurface course failure20120Extend life make safe
Cowpath Gardens / Croxdale Terrace, PelawSurface course failure10110Extend life make safe
Deneburn / Hallgarth, Leam Lane    Surface course failure16110Extend life make safe

4.24 Surface dressing

LocationReason for worksCost £kLength (metres)    Benefit
C305 Pawston Road, Barlow / High SpenPrepatch and surface dress1051250Extend life make safe
West Lane and Knobbyends Lane, WinlatonPrepatch and surface dress53610Extend life make safe
Coach Road, Lobley Hill / LamesleyPrepatch and surface dress1122080Extend life make safe
C306 Fellside Road, WhickhamPrepatch and surface dress66435Extend life make safe

4.25 Ultithin programme on unclassified roads

LocationReason for worksCost £kLength (metres) Benefit
Ridgeway, Leam LaneSurface course failure31330Extend life make safe
Byron Walk, Keats Walk, GatesheadSurface course failure41161Extend life make safe
Derwent View, WinlatonSurface course failure24304Extend life make safe
Park Avenue, Blaydon Surface course failure871Extend life make safe
Runnymede Gardens, Chopwell Surface course failure49383Extend life make safe
Larkspur Road, Whickham  Surface course failure38228Extend life make safe
Blackthorne, Sunniside Surface course failure30131Extend life make safe
Dunston Road, Dunston Surface course failure24120Extend life make safe
Heathfield Road, Low FellSurface course failure32240Extend life make safe
Holyoake Gardens, Deckham Surface course failure36261Extend life make safe

4.3 Footways

Area where work is plannedType of works being undertakenIndicative cost (£k)Length (m)Benefits
Mountside Gardens, Dunston HillReplace paving flags with asphalt42227Safety and improved environment.
Queens Court, TeamsReplace paving flags with asphalt46215Safety and improved environment.
Jackson Street phase 2, GatesheadReplace paving flags with asphalt63157Safety and improved environment.
Grisedale / Brampton Gardens, Low Fell (east side)Replace asphalt with stone paving and kerb works43325Safety and improved environment.
Church Road, Sheriff HillReplace paving flags with asphalt2293Safety and improved environment.
Coldwell Park Drive, FellingReplace paving flags with asphalt35154Safety and improved environment.
Redemarsh, Leam LaneReplace paving flags with asphalt42277Safety and improved environment.
Jackson Street phase 1 Re-lay paving flags92157Safety and improved environment.
B6317 Whickham Front StreetRenew existing bitmac footway surfacingTBC220Safety and improved environment.
Burn Road, BlaydonRenew existing bitmac footway surfacingTBC290Safety and improved environment.
Dunston BankRenew existing bitmac footway surfacingTBC450Safety and improved environment.
Chester Gardens, CrawcrookRenew existing bitmac footway surfacingTBC110Safety and improved environment.
Redemarsh, Leam LaneReplace existing flagged footway with BitmacTBC92Safety and improved environment.
B6315 Woodside Lane, GreensideReplace existing flagged footway with BitmacTBC140Safety and improved environment.

4.4 Structures and bridges

Area where work is plannedType of works being undertaken Indicative cost (£k)Benefits
Tyne BridgeMajor maintenance with Newcastle City Council41,400Major maintenance required to ensure future durability of structure. Note Gateshead contribute 40% of cost.
Gateshead viaduct Principal inspection and PTSI stage 1330Duty to inspect and maintain structures. Investigation of known issues.
Gateshead viaduct Demolition18,000Maintenance burden reduced.
Allows town centre regenerationRedheugh Bridge principle inspection TBCDuty to inspect and maintain structures.
Redheugh Bridge

Coping stabilisation

Drainage repairs

1,000Address risk of spalled coping units and piers.
Lamesley RoadBrick parapet repair10Maintain safety features
Riding Mill Lane public right of way Bridge replacementTBCBridge does not have parapets and is at the end of its life. Repacement options being considered.
Lintzford RoadStabilisation of carriageway

150 (design)

TBC (construct)

Reduces risk of landslip and loss of key transport corridor.
Scotswood bridgePrinciple inspectionTBCDuty to inspect and maintain structures.
Blaydon viaductPrinciple inspection Duty to inspect and maintain structures.
The Gateshead Millennium BridgePrinciple inspection including mechanical and engineeringTBCRefurbishment of some mechanical and engineering elements required to ensure continued use of opening.

4.5 Street lighting

Area where work is plannedType of works being undertaken Indicative cost (£k)Benefits
Borough wideColumn Replacement Program1.5mUpgrading lighting infrastructure
Borough wideHigh Mast Lantern Replacement61Upgrade the lighting at major conflict areas
Metrocentre ring roadDuct/cable replacement150Infrastructure improvement
Team ValleyDuct/cable replacement    100Infrastructure improvement
Main Gate, Team ValleyLED lantern replacement25Upgrade the lighting at major conflict areas

4.6 Drainage /flooding

Area where work is plannedType of works being undertaken Indicative cost (£k)Benefits
Holburn laneInstallation of two dams and culvert100To alleviate flood risk to private land and improve existing culvert inlet making it better for future maintenance.
Gully repairs Repair of existing restricted gulliesNot applicableMaintenance of existing gullies to drain existing highway.
Watergate Park reservoirImplementation of erosion control500To bring the reservoir to latest specification to reduce risk of life in an event.
Ridgeway surface water and flooding alleviation scheme (SWFAS)Installation of new manhole and gullies.40To alleviate flood risk to highway for local community.
Durham Road SWFASRemoval of existing drainage and installation of new highway drainage.TBCTo alleviate flood risk to highway for local community and business.
Arran Road SWFASInstallation of new gully into footway to alleviate flood risk20To alleviate flood risk to highway for local community.
Community Alert System (CAS)Installation of bollards 10To inform customers within the community of flood risk that will provide time for customers to prepare.

To summarise we plan to:

  • resurface over 55 streets
  • improve more than 20 footways
  • repair and inspect 11 structures
  • replace hundreds of lighting columns
  • carry out 10 flood relief schemes

In an average year we repair 3318 potholes.

Section 5 - Streetworks

Gateshead Streetworks permit scheme was established in 2020. It has grown from a team of one Streetworks Controller, two Permit Support Officers and one Inspector to three Permit Inspectors and three Permit Support Officers under the supervision of the Streetworks Controller.

The team assess permits to manage and minimise delays and other impacts on all road users, promote best practice and enhance coordination, collaboration, and cross boundary cooperation across the North East region, particularly in the area covered by the North East Combined Authority. The team actively drive compliance with inspections and issue penalties and fines, in accordance with the legislation, when noncompliance is identified.

It's important that new resurfacing works are not undermined by being repeatedly dug up by utility companies and we use our Streetworks permit powers to manage this.

Key to this is coordination and good working relationships between the council and utility companies with the council being seen to be acting fairly to all parties and having regular coordination meetings.

Operationally we monitor the permit durations and challenge any that seem excessively long as well as seeking to optimise resource allocation from the utility side. We carry out regular street works inspections to make sure if a road has to be dug up it is properly reinstated to appropriate standards with any issues addressed promptly.

We also focus on any defects that may be apparent when the reinstatement has been finished and also at regular prescribed intervals after the reinstatement has been completed.

Section 6 - Climate change and resilience

6.1 Decarbonising maintenance operations

The council has established a carbon reduction group in partnership with Tarmac which has the council's current term maintenance contract. We have begun using warm lay road resurfacing materials (instead of high carbon, hot lay materials) and a new thinner surfacing product with a much-improved finish and greater longevity both of which have much lower (carbon footprint).

The annual carbon reduction from the use of warm lay materials for resurfacing and ultrathin materials equates to some 64 tons of CO2e (the standard measurement of greenhouse gas) in the 2023 to 2024 programme. The aim going forward will be to find greater annual savings to improve on this baseline and to use this information to assist  the decision-making process when it comes to choice of materials, treatments and intervention timing. This work will allow us to develop a new highway decarbonisation policy/strategy in 2025 for highway infrastructure to add to the work already providing carbon reduction benefits with street lighting and traffic signals.

Recent improvements in management of our traffic signals with a new asset management system and inventory is allowing us to target sites for repair on obsolescence and reliability. The conversion of all 180 traffic signal sites from the existing tungsten halogen lighting to LED is now very much a priority with some 50 sites outstanding.

The conversion is expensive, however the benefits in energy and carbon savings as well as reliability are excellent. In 2023 to 2024 a successful bid to central government has provided a grant of over £100,000 to be used on upgrading old equipment. The successful LED conversion programme with our street lighting estate has also provided energy and carbon savings and was a key target in earlier years of the HAMP.

6.2 Network resilience

A key aim of the Gateshead HAMP is to improve the resilience of the highway network to deal with severe weather events particularly flooding. For the last 2 years we have been using a gulley management software programme to look at the performance of all our 30,000 highway drains. The information is used to identify areas requiring greater attention at sites with known flood risk issues. This information will allow us to develop a strategy to make the network more resilient with resources directed to the areas of greatest need. The same data is collected on culverts and other blockage points to ascertain which screens and entrances need to be cleaned more regularly and in advance of bad weather forecasts.

Resilience in terms of choosing the correct surfacing materials to last in different areas of Gateshead has already been discussed in section 3.2 similarly carefully monitoring faults and frequent issues relating to traffic signals and street lighting and changing to longer lasting equipment also builds in resilience into the network.

Section 7 - Further information
